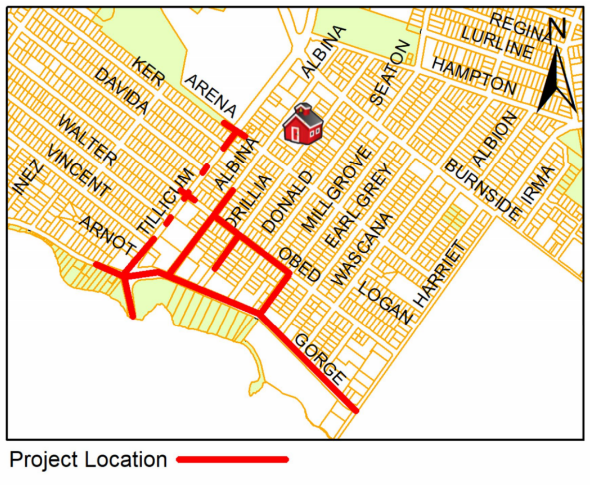

Albina Gorge Tillicum Upgrades
Why are we doing this project?
We want safer roads for all road users across Saanich, and in the Gorge Tillicum Area. This project will realize priorities identified in Saanich’s Official Community Plan, Active Transportation Plan, and Road Safety Action Plan and among other planning documents. And will fill existing gaps in our cycling network connecting City of Victoria and Esquimalt.
Gorge Road (between Tillicum and Harriet) has pedestrian and bicycle network improvements that are priorities in the Active Transportation Plan (2024).
What we are doing:
- 307 meters of sanitary sewer replacement
- 478 meters of storm drain replacement
- Albina Lift Station Replacement

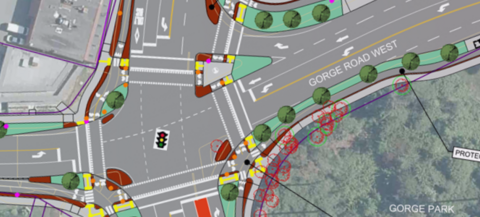

- Protected cycling facilities
- Tactile walking strip indicators for visually impaired.
- Intersection upgrades at Gorge and Tillicum, Gorge and Harriet, Tillicum and Arena
- Boulevard landscaping
- improved street lighting
- External utility relocation of Fortis, Hydro and Telus

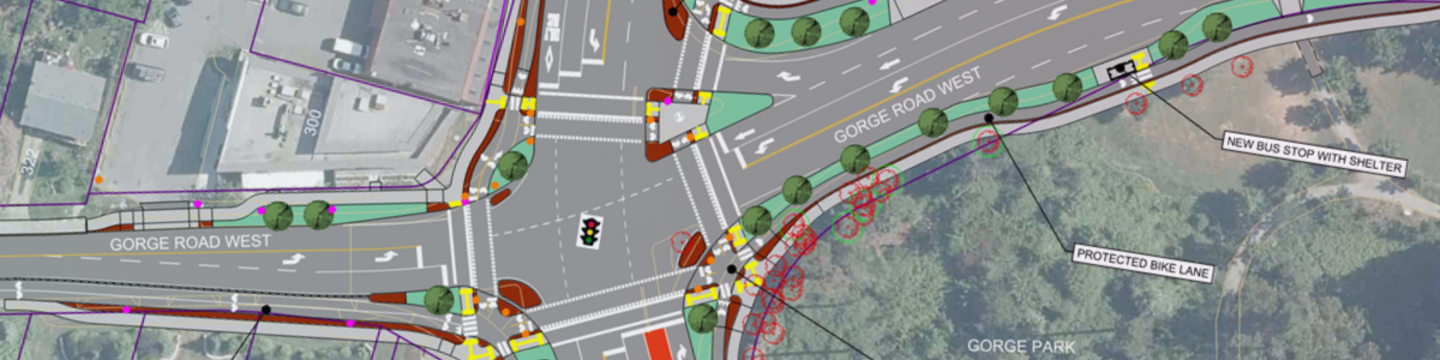

- Bus stop relocations and service improvements
Construction
Construction is expected to take approx. 24 months to complete. And will be completed in a phased approach.
- Phase 1 – Lift Station (2026)
- Phase 2 – Test and Injection Grouting (2026)
- Phase 3 – Active Transportation Upgrades (2027)
During construction, you can expect typical construction inconveniences such as more noise and road closures with access to local traffic only. Contractors are expected to ensure there is always a safe pedestrian access and that residents can access their properties. We expect that businesses will be able to operate as normal and that there will not be any direct impacts to the services they provide.
Saanich will be working closely together with the contractor to minimize the impacts of the construction on the residents and business owners and appreciate your understanding and patience as we work to complete this exciting project for your community.
